Defend Truth

GROUNDUP

Massive Gugulethu housing project for families evicted under Group Areas act dead in the water

Massive Gugulethu housing project for families evicted under Group Areas act dead in the water

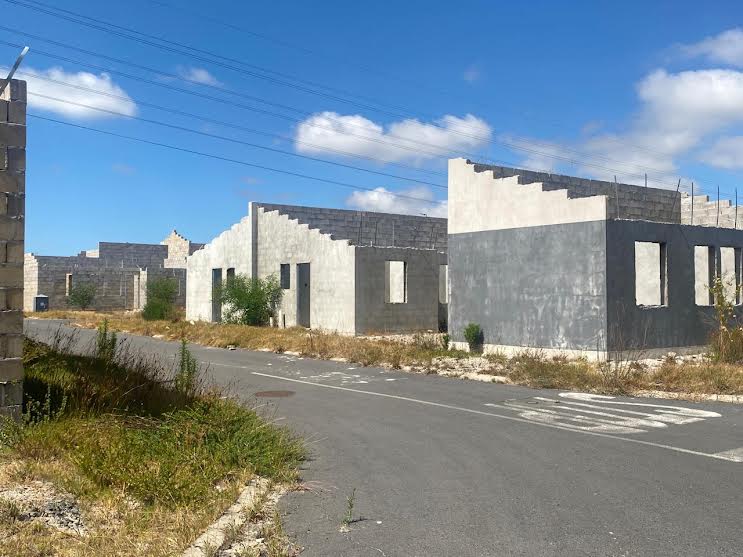

Only 23 units out of 570 in the Gugulethu housing project launched in 2018 have been completed. (Photo: Siphokazi Vuso)

Successive failure of construction companies leaves families waiting.

In 2017, the City of Cape Town set aside R105-million to build more than 570 homes for families who had been evicted under the Group Areas Act and moved to Gugulethu. More than five years later, only 23 houses have been completed.

Three companies, Ghika Construction, Simply Do Construction and Masikhule Projects, were appointed in 2018, to build the units, according to Western Cape Department of Infrastructure spokesperson Jandré Bakker.

The project is known as the “Gugulethu erf 8448 housing project”.

Simply Do started construction in August 2019. Gikha started construction in October 2019. Masikhule started in June 2020.

Construction was expected to take 11 months.

But the project has been bedevilled by the failure of one contractor after another and by the Covid lockdown. Gikha and Simply Do completed no units at all; Masikhule built 27 units but these were incomplete and “several defects and snags were identified”, said Bakker.

Masikhule and Simply Do had ceded their contracts to Boon Africa, which approached the department in July 2023, said Bakker. Boon Africa had committed to complete the 27 units built by Masikhule and to build more units. But by the end of October Boon Africa had failed to meet its commitments, he said.

A new contractor would now be appointed by the City of Cape Town, Bakker said.

When approached by GroundUp, Boon Africa Construction Director Collen Matimba said that the contract had been abruptly terminated before the company could complete the work. He did not say why it had taken so long to build the houses. We could not reach the other companies except for Masikhule who referred us to Boon.

Mayco Member for Human Settlements Carl Pophaim said Ghika Construction and Simply Do Construction had abandoned the site in 2020 and their contracts had been terminated. “The contractors’ major challenge was their limited capacity and ability to effectively execute the works,” he said.

Masikhule Projects remained on the site but when it failed to meet targets its contract was terminated in July last year.

Gugulethu Ward 39 councillor Thembinkosi Mjuza said families were demanding answers.

“The development has been facing challenges since it started.“ He said some beneficiaries had died while waiting for their houses.

Housing beneficiary Sabelo Jele, who has been on the housing waiting list for 30 years, said they were losing hope.

“I submitted my application for a house on 16 August 1993. I have been waiting for 30 years. When the project started we were very hopeful that our lives would change. But all we’ve got are empty promises from the City.”

Gugulethu

Sabelo Jele says he is losing hope that his house will ever be finished. (Photo: Siphokazi Vuso)

Ncedeka Mgwele said her husband Thulani Stokwe died waiting for his home. “It was his dream to move the family into a home that is his own. But because of all the delays, he died before he could see that dream,” she said.

Gugulethu Uprising secretary and community activist Marc Matebe said the City had failed the families. We are calling on the City of Cape Town to ensure that the houses are complete by June, ” he said.

Pophaim said a new contractor would start work on the site this month, with the goal of completing the project within 24 months. The families would be kept informed, he said. DM

First published by GroundUp.
